Below is the process we follow to ensure a great outcome for all:
WHS documentation including Work Method Statement, Site Specific Safety Plan, Construction Schedule
Service location before commencing any works, DIAL BEFORE YOU DIG
Site establishment and construction fencing to surround site
Soil tests and soil amendments applied
Supplied and install a temporary irrigation system to the fields

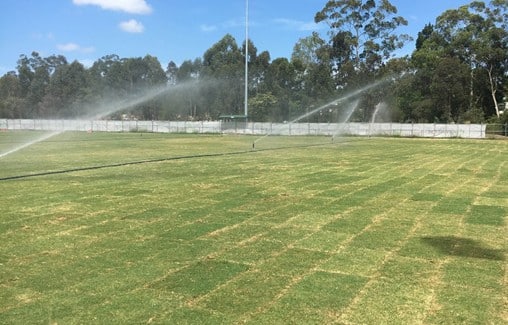

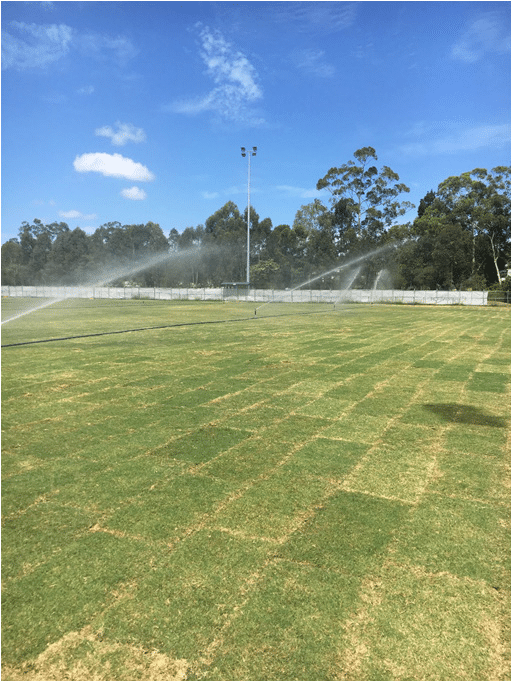

Installation of temporary irrigation system installed and tested priori to tufing
Supplied and apply soil conditioner, RRA Organics
Blecavate 3 passes

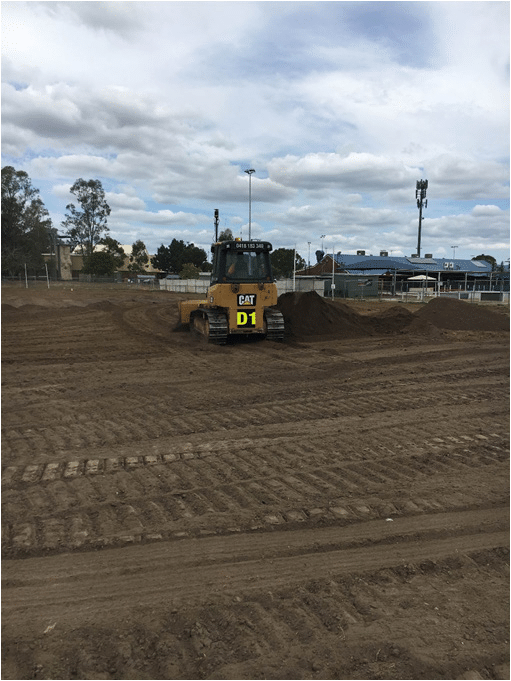

Laser Level Field and Final Trim
Supplied and Install certified and inspected 15,000 sqm Wintergreen turf
Supplied and apply Ronstar and starter fertiliser
Supplied and apply pesticide
Supplied and apply controlled release fertiliser
1st mow and Sweep
2nd Mow, Sweep and Topdressing 10mm 16 3rd Mow and Sweep
4th Mow, Sweep
5th Mow Sweep and Topdressing 10mm
Maintenance of field for 13 week included temporary fence line, mowing and whippering
Line marking
At time of handover we had to ensure less than 1% weeds are present in the playing surface
Duringturfmaintenanceperiod we had to guarantee 100% coverage and establishment of turf
We had to provide “As Constructed Drawings” to be provided to the MBRC representative
Leave the field in a condition ready for use upon completion of the project

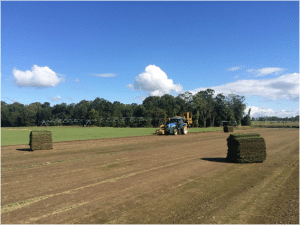

4 Days after the turf was installedAfter surveying the site and working with the lay of the land, the above designed was proposed as the best solution for the playing surface.Shaping the fields to design with a machine control GPS low ground pressure dozerTurf being harvested for the field 15,000 sqm in 3 days.
